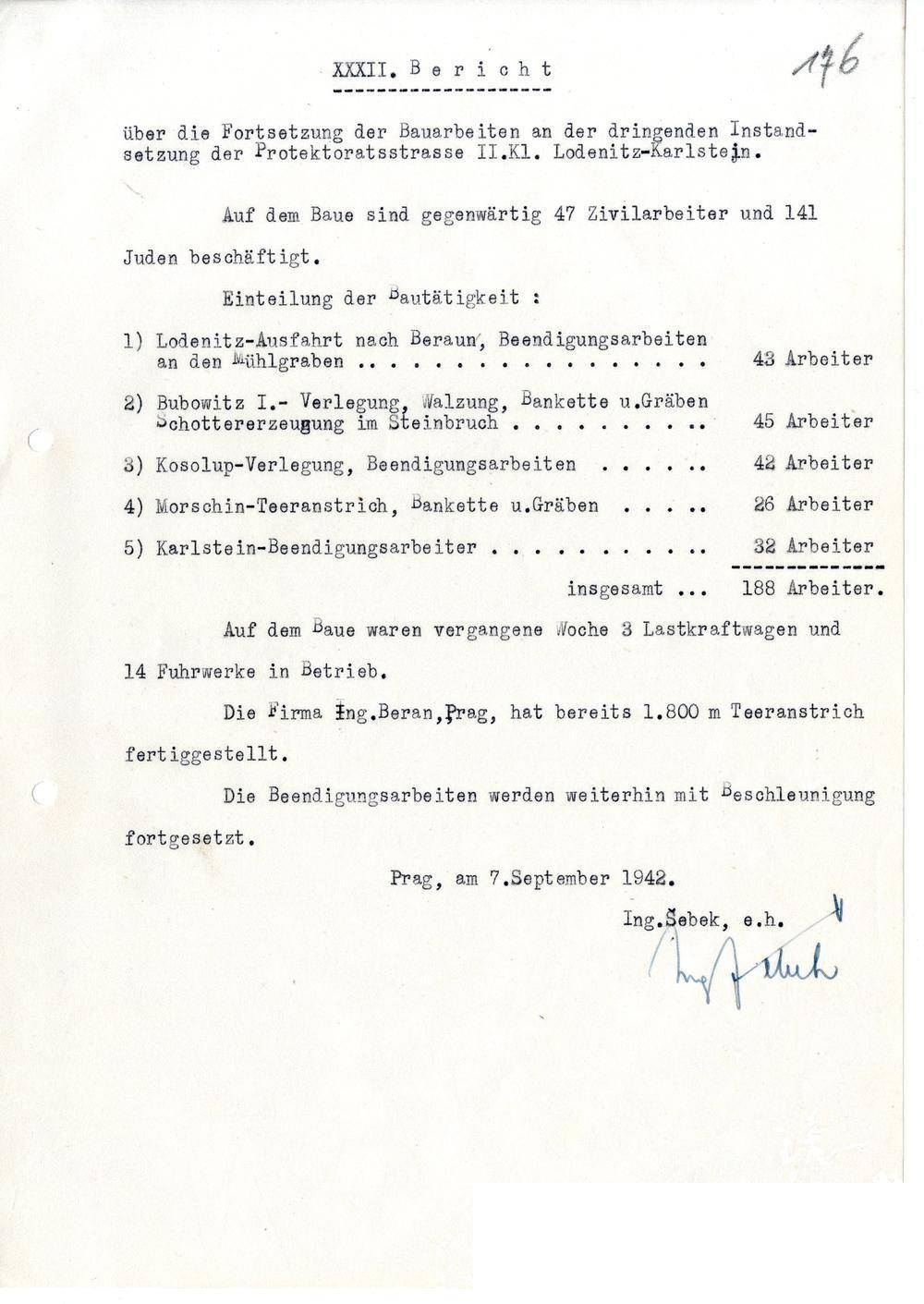

146 XXXII. B e r i c h t on the continuation of the construction work on the urgent maintenance of the Protectorate Street II. Kl. Lodenitz-Karlstein. On the construction there are currently 47 civilian workers and 141 Jews employed. Classification of the building activity : 1) Loderitz exit to Beraun, finishing work at the mill ditch . . . 43 workers 2) Bubowitz I.- laying, rolling, banquets and graves Graves production in the quarry . . . ... 45 workers 3) Cosolup laying, finishing work . .. . . 42 workers 4) Morschin tea painting, banquet and tombs . . .... 26 workers 5) Karlstein finishing workers . . ........ 32 workers total ... 188 workers. Last week, 3 trucks and 14 trucks were in operation on the construction site. İng. Beran,Prag, has already completed 1 8OO m of tarpaulin. The finishing work will continue with acceleration. Prague, September 7, 1942. Ing. Sebek, e.h.V me tuh
