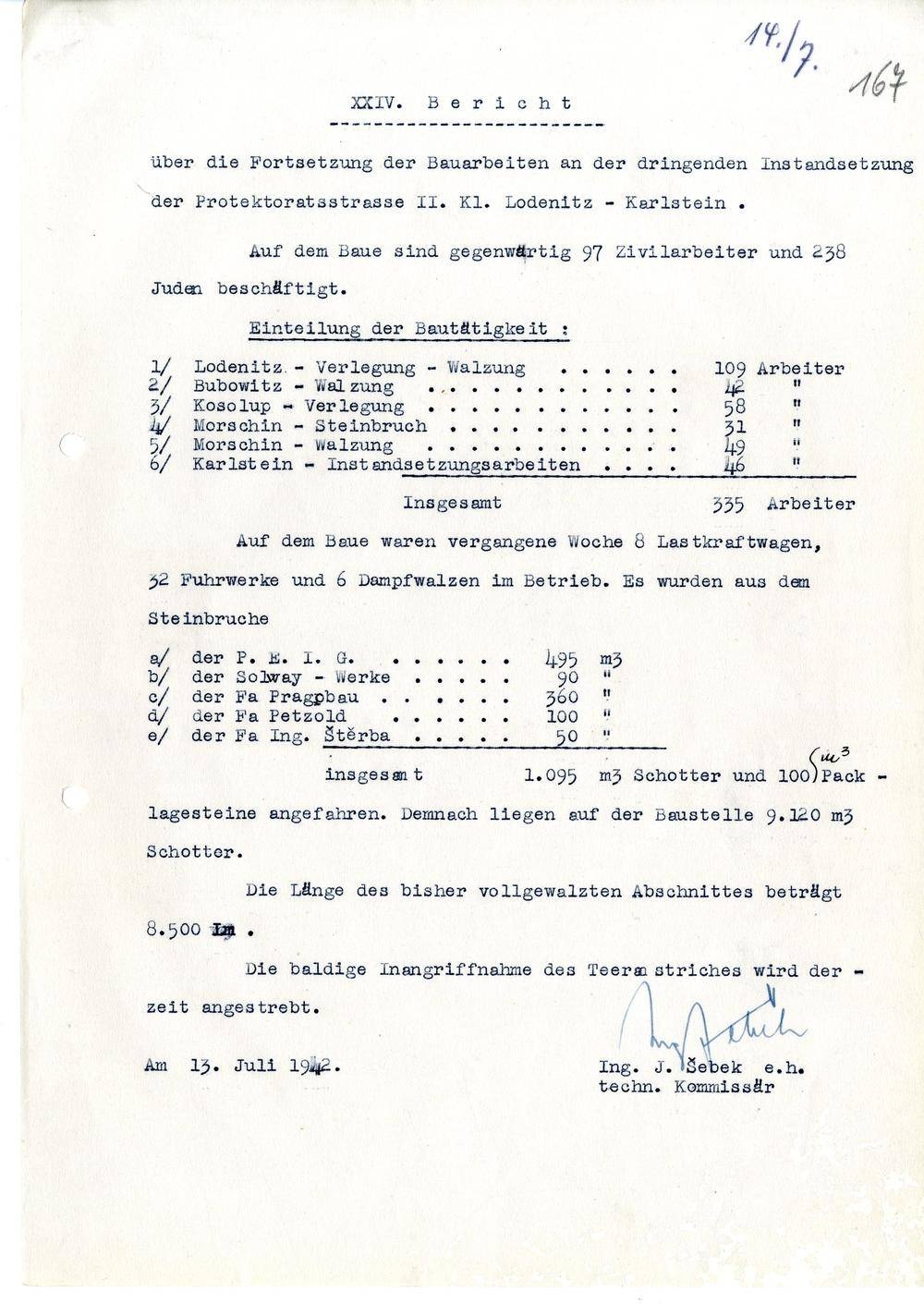

STÁTNÍ TAJEMNÍK U ŘÍŠSKÉHO PROTEKTORA V ČECHÁCH A NA MORAVĚ, PRAHA, inv. 2753, sig. 109-14/56 Page 151 · 151 of 252
STATE SECRETARY FOR THE RUSSIAN PROTECTOR IN THINGS AND IN MORAVA, PRAGUE, inv. 2753, sig. 109-14/56
English Translation
14.17. 167 XXIV. B e r i c h t on the continuation of the construction work on the urgent repair of the Protectorate road II. Cl. Lodenitz - Karlstein. At present 97 civilian workers and 238 Jews are employed on the construction site. Classification of the building activity : OUEWNE Loderitz. - laying - rolling 109 workers Bubowitz - rolling 42 "1 Kosolup - laying 58 "1 Morschin - quarry .... "1 Morschin - Walzung " Karlstein - Renovation work " A total of 335 workers On the construction last week were 8 trucks, 32 trucks and 6 steam rollers in operation. There were from the quarry 2 of P. E. I. G. ...... 495 m3 of Solway - Works ... 90 " of the Fa Pragpbau . . 360 " of Fa Petzold . 100 " e/ of Fa Ing. Štěrba ..... 50 (u^33} in total 1,095 m3 of gravel and 100)Pack - stacks are approached. Accordingly, there are 9.l20 m3 gravel on the construction site. The length of the so far fully rolled section is 8,500 Lm. The early approach of the Teera stroke is sought at the time. On 13 July 1942. Ing. J. Šebek e.h. techn.
