STÁTNÍ TAJEMNÍK U ŘÍŠSKÉHO PROTEKTORA V ČECHÁCH A NA MORAVĚ, PRAHA, inv. 2753, sig. 109-14/56 Page 125 · 125 of 252
STATE SECRETARY FOR THE RUSSIAN PROTECTOR IN THINGS AND IN MORAVA, PRAGUE, inv. 2753, sig. 109-14/56
English Translation

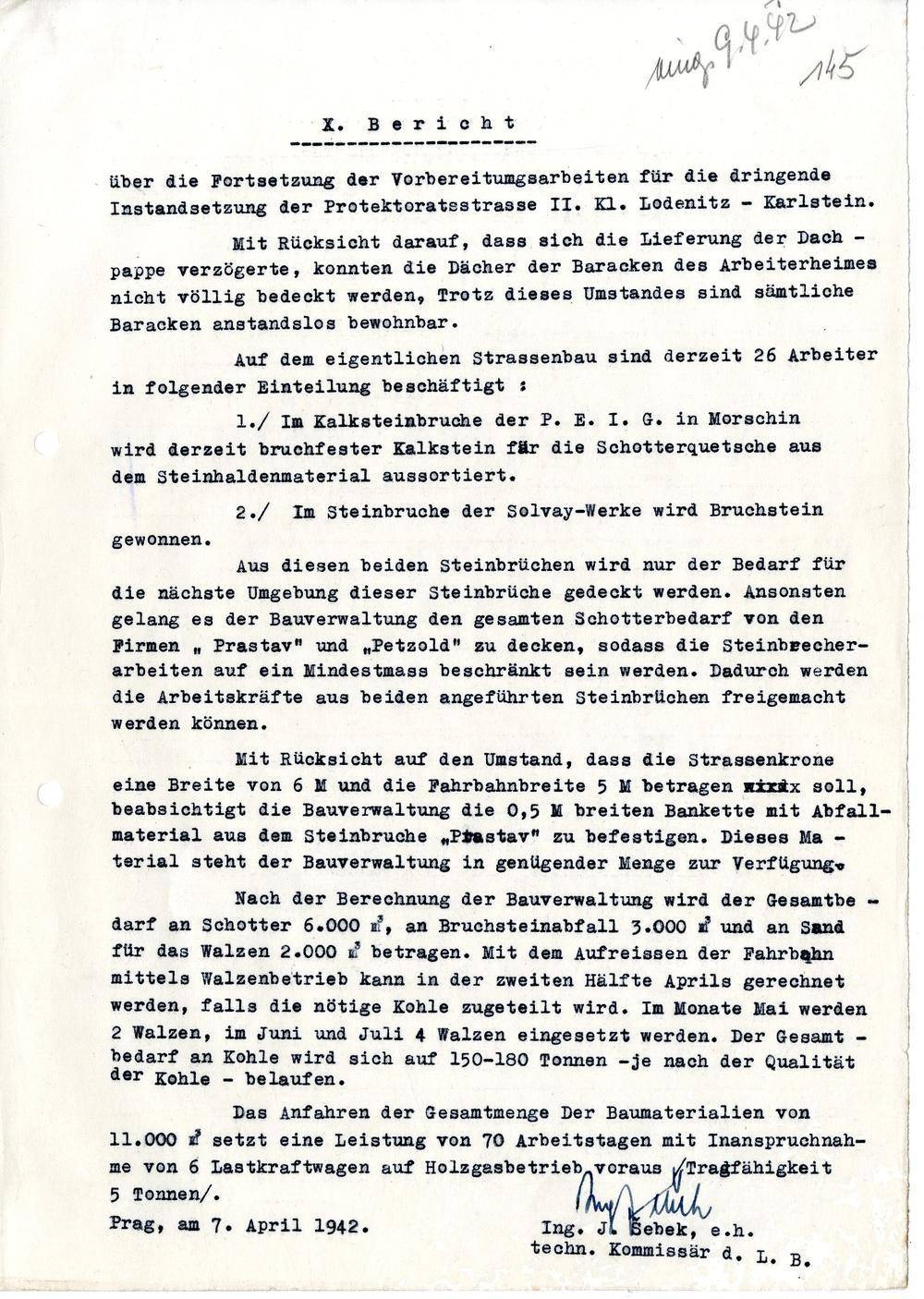

145 Mig.9.4.22 X. B e r i c h t about the continuation of the preparatory work for the urgent repair of the protectorate road II. Kl. Lodenitz - Karlstein. Considering that the delivery of the roof board delayed, the roofs of the barracks of the workers' home could not be completely covered, despite this circumstance all barracks are unreservedly habitable. 26 workers are currently employed on the actual road construction in the following classifications : l./ In the limestone quarry of P. E. I. G. in Morschin, the crushed limestone is currently being sorted out for the gravel crushes from the quarry material. 2./ The quarry of the Solvay works produces broken stone. From these two quarries only the need for the next environment of these quarties will be met. Otherwise, the building management managed to cover the entire gravel requirement of the Pirmen "Prastav" and "Petzold" so that the stone beekeeping work will be limited to a minimum. This will allow the workers to be freed from both stone quarries mentioned above. Considering that the crown of the road should be 6 m wide and the road width 5 m wide, the building management intends to fix the O,5 m wide banquet with waste material from the quarry "Ptastav". This ma - terial is available to the building management in sufficient quantity. After the calculation of the building administration the total area will be - may amount to 6.000 m in gravel, 3,000 m in broken stone waste and 3.000 m on sand for rolling 2.Ooo 2. Rising the road by means of roller operation can be expected in the second half of April, if the necessary coal is allocated. In May, 2 rollers will be used, in June and July, 4 rollers. The total amount of coal required will be l50-l80 tonnes, depending on the quality of the coal. Starting the total amount The construction materials of 11.ooo set an output of 70 working days with demand of 6 trucks on wood gas operation,out of a capacity of 5 tonnes/. Ame tuh Prague, on 7. Ing. Jl Šebek, Technical Commissioner, L.B.
